How Do You Choose a Kitchen Remodeling Contractor?

July 19, 2023 · Updated September 30, 2026

How do you choose a kitchen remodeling contractor? EcoBuild Plus guide cover showing a bright white kitchen with a marble island

Key takeaways

  • Settle the layout before you call anyone. Three quotes on an undecided kitchen are three quotes on three different kitchens, which is why the numbers come back so far apart.
  • The work triangle has real numbers behind it. Each leg between 4 and 9 feet, no more than 26 feet in total, plus at least 42 inches of clear aisle anywhere you’ll be working.
  • What sits inside the wall decides most of the price. Load and plumbing stacks stay invisible until somebody opens the wall up, and either one can move the number by thousands.
  • Ask every company the same questions, then tie payment to milestones rather than dates. A contractor who would rather skip the permits is telling you how the rest of the job will go.

To choose a kitchen remodeling contractor, work out what the room can physically become before you ask anyone for a price. Once the layout is settled, the right contractor is the one who questions your plan rather than the one who agrees to it fastest.

Why every contractor gives you a different price

Contractors give you different prices because each one is pricing a different kitchen. Most people call at the wrong moment. They pick a countertop, save a folder of photos, then ring three companies, and since nothing has actually been decided, every quote rests on its own set of assumptions.

There’s a better order to go in. Work out what the room can realistically become before anyone quotes on it, which normally means finding out what sits inside the walls you’d like to move.

What follows covers both halves, layout first, hiring second, with the quirks of Chicagoland housing in between.

Start with the layout, not the countertops

Layout is the one thing you can’t redo. Cabinets and worktops you can swap whenever the budget recovers. Move a wall twice, though, and you’ll wish you’d spent another hour on the drawing.

Almost everything people love or hate about a finished kitchen comes back to two things: whether the parts you use most sit close together, and whether there’s enough clear floor for two people to exist at once.

What the work triangle actually measures

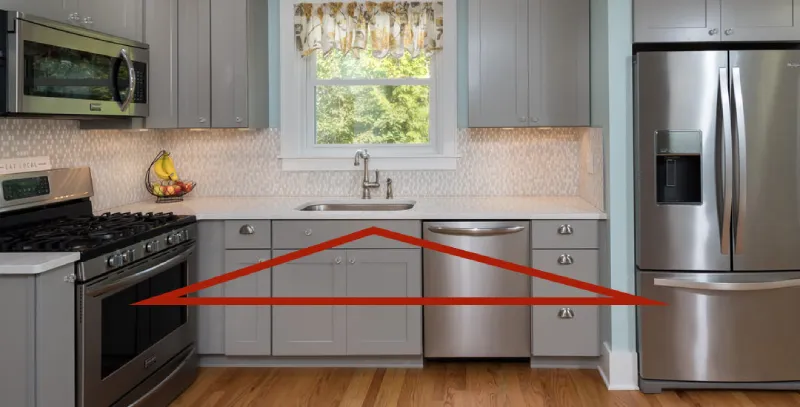

Kitchen work triangle connecting the gas range, sink and refrigerator in a U-shaped kitchen with gray shaker cabinets

The work triangle comes up in almost every guide to kitchen design, though the actual measurements rarely make it in. Those numbers are the useful part.

The triangle is the path between your sink, your cooking surface and your refrigerator. The National Kitchen and Bath Association (NKBA) publishes planning guidelines for it.

GuidelineMeasurement
Each leg of the triangleBetween 4 and 9 feet
All three legs added togetherNo more than 26 feet
ObstructionsNothing full height, like a tall pantry, should interrupt a leg
TrafficThe main route through the room shouldn’t cut across the triangle

Put the sink and the stove less than four feet apart and you’ll be knocking into your own cabinet doors. Put them more than nine feet apart and you’ll feel it every time you carry a hot pan across the room.

The 26-foot limit is the one people miss. It usually happens in a big open kitchen, where the island gets pushed out to fill the space until the refrigerator ends up on the far side of the room from the stove. The photos look wonderful. Cooking in it is a hike.

These are guidelines, not rules. Nobody inspects a kitchen against them. They’re simply what most people find comfortable to work in.

They also assume one person doing the cooking. If two of you are usually in there at once, give each person their own stretch of counter, with the sink out of the way of both.

Which layout you’re working with

LayoutSuitsWatch out for
Single wallSmall apartments, narrow roomsThe triangle flattens into a line. Very little counter space.
GalleyLong narrow rooms, common in older homesTwo facing runs need real clearance, or two people can’t pass
L-shapedOpen plan, corner roomsThe corner cabinet is dead space without proper hardware
U-shapedMedium to large square roomsEfficient, though tall uppers on three walls can feel closed in
L with islandOpen plan with room to spareThe island lands too close or too far. Clearance decides it.
PeninsulaRooms too narrow for a true islandA fair compromise, yet it creates a pinch point at the open end

Not sure which one you’ve got? Stand in the doorway, then count the runs of cabinet. One run is a single wall. Two facing each other is a galley. Two meeting at a corner is an L.

The measurement nobody checks

Picture the dishwasher door down, someone trying to get past it to the refrigerator. That gap is what you’re planning.

GapMinimum
Work aisle, one cook42 inches
Work aisle, two cooks48 inches
Walkway with no work surface36 inches

Forty-two inches looks roomy on a drawing. In real life it has to swallow an open dishwasher door with somebody standing in front of it. This is the regret we hear most often once a kitchen is finished, though on paper it costs nothing to fix.

What’s behind the wall decides what’s possible

Most layout changes worth making involve taking out a wall or shortening one. What sits inside it decides how straightforward that is, and none of it is visible until somebody opens the wall up.

  • Load. A load-bearing wall can still come out. It needs a beam and posts sized by an engineer, which means a structural permit. In older houses the load doesn’t always travel where you’d expect, particularly where somebody added on over the years.
  • Services. Plumbing stacks or electrical, sometimes both. Moving a stack is expensive. Moving a few circuits usually isn’t.
  • Exterior walls. Here you get a chance most people throw away. With the wall open you can air seal and insulate properly for a fraction of what it costs later. A kitchen leaks more than people realize, thanks to everything that punches through it: the range hood duct and the recessed lights. Once the drywall goes back up, that chance is gone for twenty years.

Ventilation belongs in this conversation too, though it rarely gets planned early enough. A recirculating hood with a charcoal filter pushes grease around the room rather than out of it, so if your cooking surface sits on an interior wall or an island, you need a duct route, which limits where that surface can go.

Bigger isn’t automatically better either. A powerful hood in a tightly built house can pull air out faster than the house lets it back in, which can drag air back down a flue.

Fuel is part of the same question. Gas cooking puts combustion products into the room you’re standing in. Induction doesn’t. Our guide to the best HVAC system for indoor air quality goes further into that.

Most remodelers skip all of this. We’re Building Performance Institute certified, so air sealing and insulation are part of how we plan a kitchen, and the room gets treated as part of a house rather than as a room on its own.

Kitchens in the north and northwest suburbs

The housing here pushes kitchens in two directions, depending on when your house went up.

The older houses around Evanston and Skokie were built with the kitchen shut away at the back. Narrow, usually, with a door at each end. That gives you a galley whether you wanted one or not. Worse, it’s a galley where everyone walking through the house cuts across your work triangle.

Two fixes come up. Take out the wall between kitchen and dining room so the space becomes an L or a U. Or close one of the two doorways so traffic stops coming through. The second costs almost nothing. Hardly anybody thinks of it.

The ranches and split-levels from the 1950s and 60s around Schaumburg and Mount Prospect have the opposite problem. The kitchen is a decent size but walled off from where everyone actually sits. Opening it up is the change we’re asked for most, and the one most likely to need an engineer, since that wall frequently carries load.

Descriptions only go so far with any of this. The kitchen before and after gallery shows what these rooms looked like beforehand, which is often the more useful half.

Before you call anyone

Work through it in this order.

  1. Which layout shape the room can support, given what can’t move
  2. Where the three work points land, then whether the triangle measures up
  3. Where people walk through, and whether that route crosses the triangle
  4. Clearances. At least 42 inches for any aisle you’ll work in
  5. The hood duct route, because it limits where the cooking surface can sit
  6. Gas or induction, because that drives ventilation and air quality
  7. Then comes the enjoyable part, choosing cabinets and countertops

One through six cost nothing to change on paper. They cost a lot once work has started. Seven can change whenever you like.

For the money side, we’ve written a full breakdown of kitchen renovation costs in Chicago.

What to ask before you sign anything

Before you sign anything, ask every company the same set of questions. Once the plan is roughly settled, get three quotes in person with measurements in hand, then work down this list.

AskWhy it matters
How many kitchens like mine have you finished in the last three years?Kitchen work is its own discipline. General remodeling isn’t the same thing.
Can I see your license and proof of insurance?Illinois has no statewide general contractor license, so licensing happens locally. The City of Chicago and many suburbs issue their own. Verify the license number rather than taking the certificate at face value.
Is the crew yours or subcontracted?Neither answer is wrong. You want to know who’s in your house.
Who pulls the permits?If the answer is you, the price you were quoted isn’t the price.
What triggers each payment?Milestones, not dates.
How do change orders work?Every kitchen has at least one.
What happens if something you installed fails next year?Get the answer in writing.
Will I have a working kitchen?Answers vary enormously. It affects months of your life.

Then call two references. The questions worth asking are whether the final bill matched the quote, and whether they’d have the same crew back.

Red flags, and how payment should work

None of the warning signs look like much on their own, which is why they’re easy to talk yourself out of. A company that wants a large deposit before anybody lifts a tool, or that would rather be paid in cash, is telling you something about how it runs its books. So is a quote that arrives as one number with nothing behind it, or a salesperson who needs your signature today. Add a business with no fixed address, or one that won’t name the subcontractors it uses, and a pattern starts to form. The clearest signal of all is a contractor who’d rather skip the permits, because that decision becomes your problem when you sell the house.

Be careful with the cheapest quote. Something has usually been left out of it, or cheaper materials have been swapped in, so the difference shows up later as extra charges.

Payment should follow progress rather than the calendar. A sensible schedule opens with a modest deposit at signing, releases more once demolition and rough-in are done, releases more again when the cabinets go in, then holds the balance until the punch list has been cleared. A contractor might reasonably want extra up front to cover material deposits. Beyond that, there isn’t much justification for it.

Ask for a lien waiver with each payment, covering the main subcontractors and suppliers too. Under Illinois law, anyone who worked on the job and went unpaid can put a lien on your house, even after you’ve paid the contractor.

Get everything in writing, with every task listed rather than the job described in a sentence. Never sign a contract with blanks in it.

What a good contractor does differently

Kitchen floor plan with a tape measure and laser measure on a granite island during a kitchen remodel consultation

What a good contractor does differently is push back on your layout before pricing it. If the first conversation is about cabinet door styles, you’ve learned something about how the job will go.

Kitchen remodels typically run six weeks to four months. Permit approval often sets the start date rather than crew availability, which surprises people. Ask how the site gets managed while it’s happening, because dust containment and a temporary kitchen are what decide whether the house stays livable.

The people who would take on your kitchen start every project at the plan rather than the catalog, which is why the first conversation tends to be about walls instead of hardware. Everything else we build across Chicagoland runs the same way.
